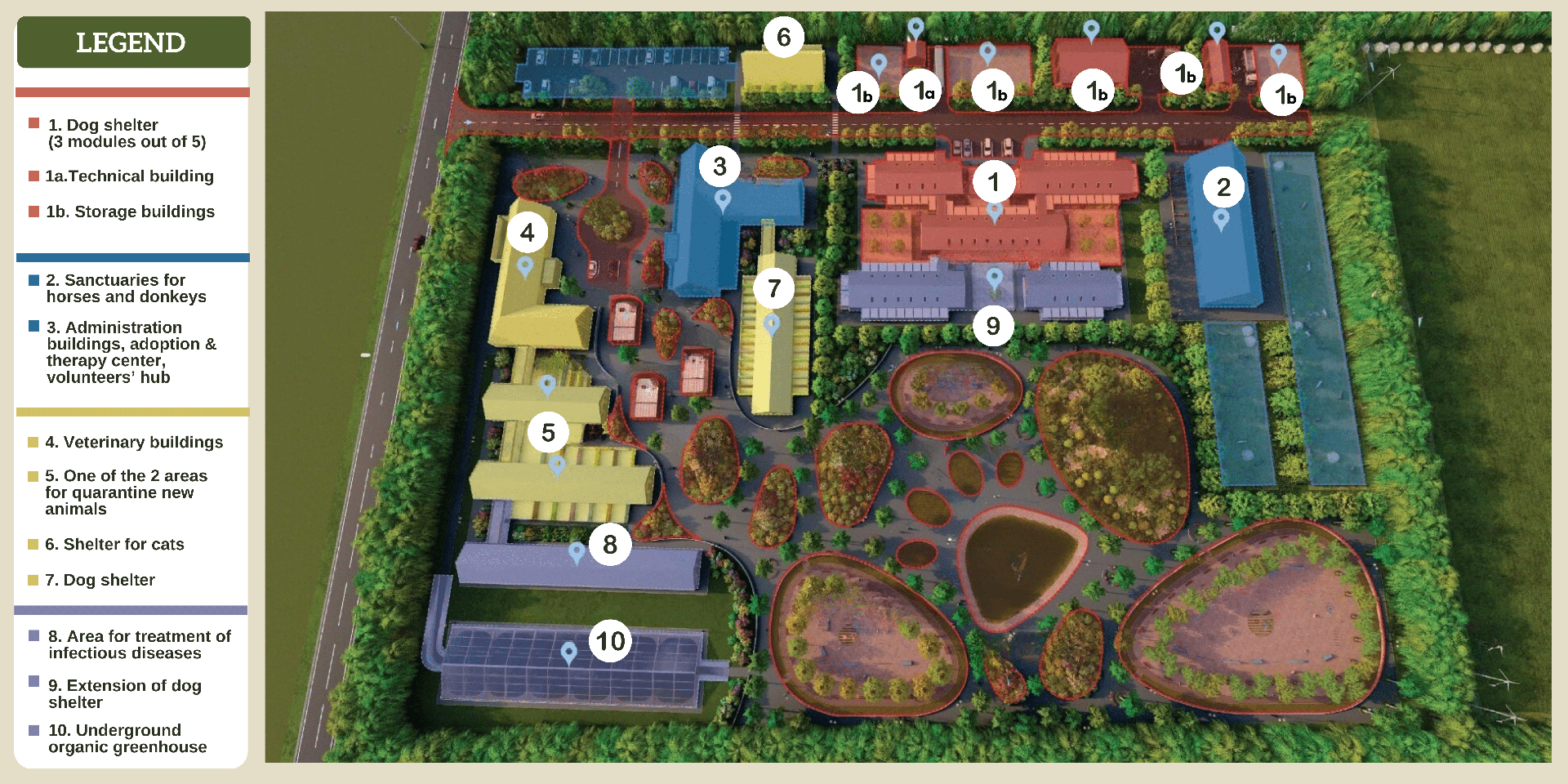

The PawzUp Center contains nine distinct buildings (as well as a number of warehouses), marked with numbers showing the order they will be built on the plan available at the bottom of this page.
Being a massive project, its entire construction work will take several years to complete. To make sure that these capital costs will not unbalance our fragile budget and that our team can absorb the logistic challenges successfully, we divided the buildings in 4 distinct phases.
Part of the phase I, the dog shelter building is the first cage-free shelter from Romania, inspired by a similar project from the US. The dog shelter design consists of 5 indoor units that interconnect. In the first phase, we will build 3 of these 5 units. Each unit has individual outdoor spaces and access to large playing grounds. The indoor areas are safe, with generous space for groups of dogs to live together like in your living room. The dog shelter will include some purpose-built rehabilitation kennels for less friendly dogs.
The dog shelter will spread over 1400 sq m and accommodate up to 240 dogs. In 2023, local authorities notified ROLDA of their advanced plans to build a road straight through our current shelter! All 12 paddocks must be demolished, so we need to relocate these dogs urgently.
We feel totally disappointed by how the Romanian authorities reacted to our concerted efforts to help animals in our community, but we must stay positive and consider this a perfect opportunity to give these dogs the chance to move into a new home and enjoy improved conditions.

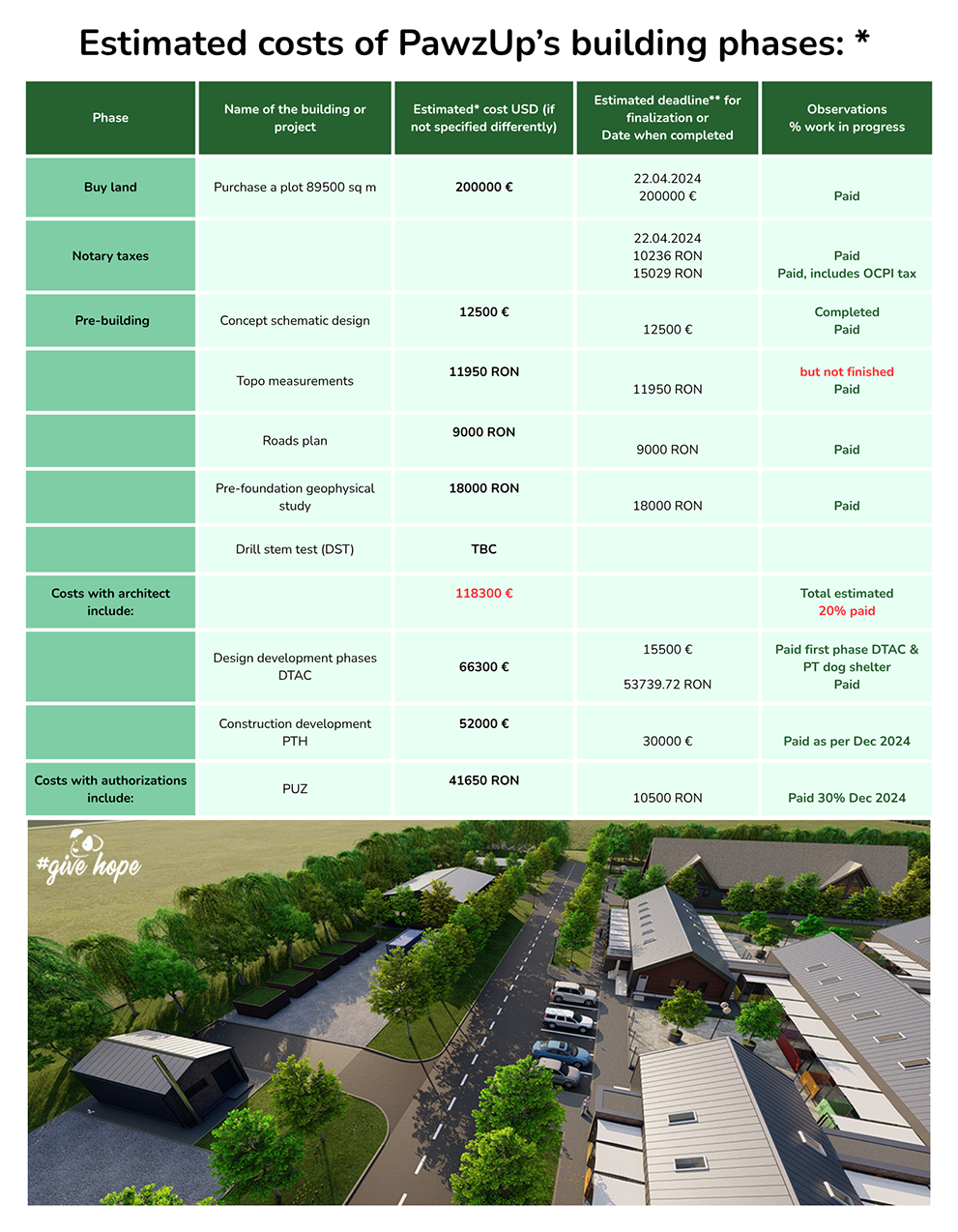

dynamic updates of expenses made and the constructions timeframe
Phase | Name of the building or project | Estimated* cost USD (if not specified differently) | Estimated deadline** for finalization or Date when completed |
Observations % work in progress |
---|---|---|---|---|
Buy land | Purchase a plot 89500 sq m |
200000 € |
22.04.2024 200000 € |
Paid |
Notary taxes | 22.04.2024 10236 RON 15029 RON |
Paid Paid, includes OCPI tax |
||
Pre-building | ||||
Concept schematic design | 12500 € |
12500 € |
Completed Paid |
|
Topo measurements | 11950 RON |
11950 RON |
but not finished Paid |
|
Roads plan | 9000 RON |
9000 RON |
Paid |
|
Pre-foundation geophysical study | 18000 RON |
18000 RON |
Paid |
|
Drill stem test (DST) | TBC | |||
Costs with architect include: | 118300 € | Total estimated 20% paid |
||
Design development phases DTAC | 66300 € |
15500 € 53739.72 RON |
Paid first phase DTAC & PT dog shelter Paid |
|
Construction development PTH | 52000 € |
30000 € |
Paid as per Dec 2024 |
|
Costs with authorizations include: | ||||
PUZ |
41650 RON |
10500 RON |
Paid 30% Dec 2024 |
|
PHASES I-IV | 16.05.2024 |
5250000 € | Estimated total cost to build PawzUp Center | |
PHASE I includes building of: | 1800000 € | |||
Infrastructure | ||||
Main road | Design Work in progress |
Completed |
||
Pipes | Design Work in progress |
In progress |
||
Electricity | Design Work in progress |
In progress |
||
Water well and pump | Search for best offer Work in progress |
In progress |
||
Water tanks | Work in progress | |||
Pluvial waters management | Design Work in progress |
|||
Technical room | Design Work in progress |
Completed Check list of building materials here |
||
Warehouse for equipment and tools | Design Work in progress |
Completed |
||
Recycling zone | Design Work in progress |
Completed Check list of building materials here |
||
Waste disposal composting area | Work in progress | |||
Platform for wastewater treatment plant | Work in progress | |||
Dog shelter (3 modules from 5) | Check list of building materials here | |||
Design Work in progress |
Completed |
|||
Running areas and outdoor spaces for dogs | Work in progress | |||
Park | Work in progress | |||
PHASE II includes | 1480000 € | |||
Sanctuary for horses and donkeys | 380000 € | |||
Outdoor spaces for horses | ||||
Outdoor area for donkeys | ||||
Administration building, adoption & therapy center, volunteers’ hub | 600000 € 500000 € |
|||
Parking area | ||||
PHASE III includes | 1700000 € | |||
Veterinary building | 550000 € | |||
One quarantine area | 500000 € | |||
Area for treatment of infectious diseases | ||||
Shelter for cats | 250000 € | |||
Extension dog shelter | 400000 € | |||
PHASE IV | tbc | |||
The remained 2 modules of dog shelter | ||||
Second quarantine area for new animals | ||||
Underground organic greenhouse | ||||
Other costs | 270000 | Estimated other costs | ||
Planting trees for wind break, living fence to block noise, reduce pollution | not fully competed |
10711 RON |
80% work in progress Paid |
|
Power generator | ||||
Wind turbines | ||||
Solar panels | ||||
Fencing the property |
